ODB System

Decommission oil-filled cables without digging them up.

Oil-filled cables that have carried power for decades still hold large volumes of dielectric insulating oil in their paper matrix — a standing risk to soil and groundwater once the cable is out of service. The ODB System removes that oil biologically, in place, by repeatedly injecting bacteria selected specifically to feed on dielectric oil.

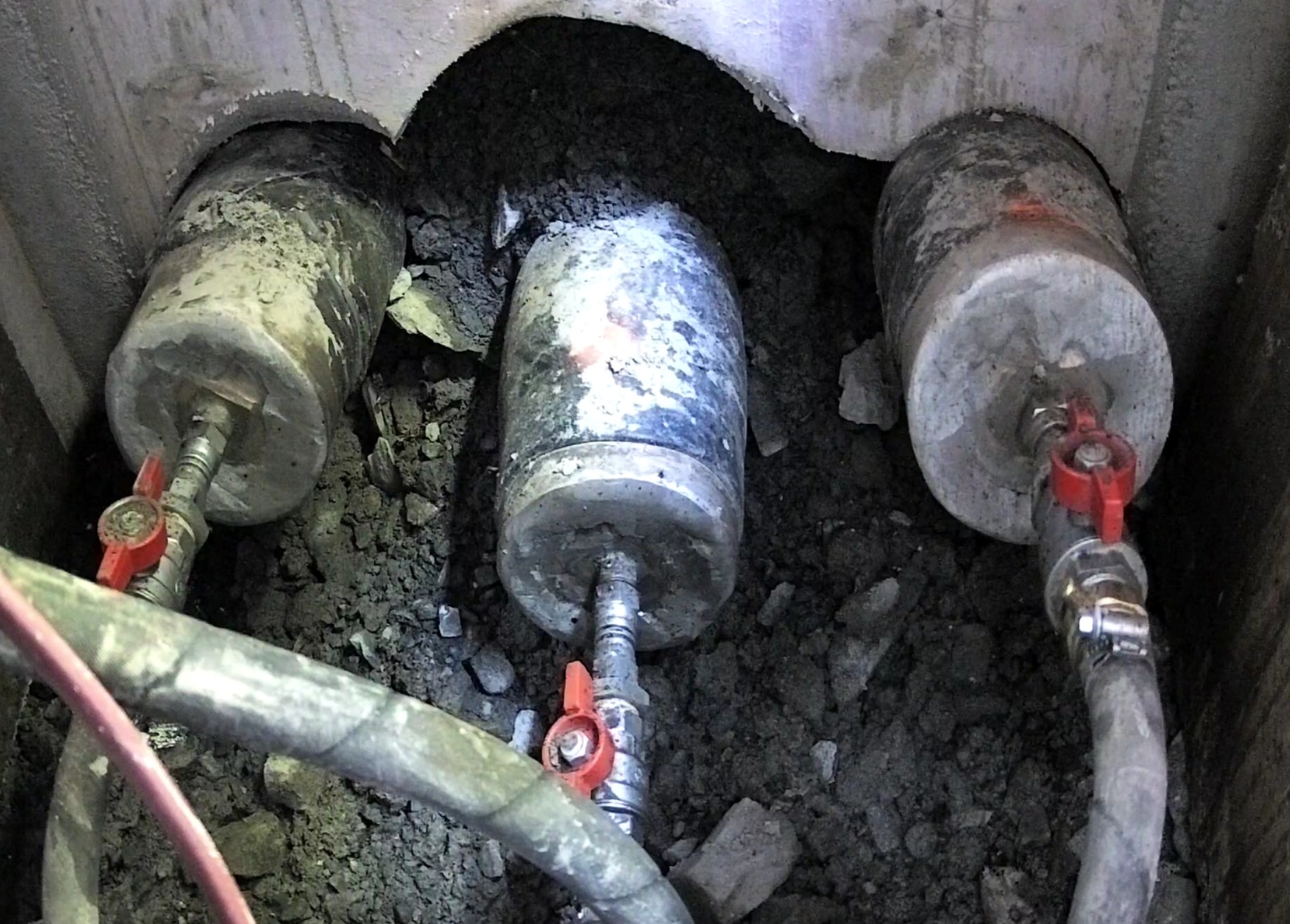

Three sealed oil-filled cable ends in an open jointing pit, fitted with red ball valves and hoses for bacterial circulation
Field connection — three oil-filled cable ends in an open jointing pit, valved and hosed for circulation. This is where the ODB System is coupled to the cable, in situ.

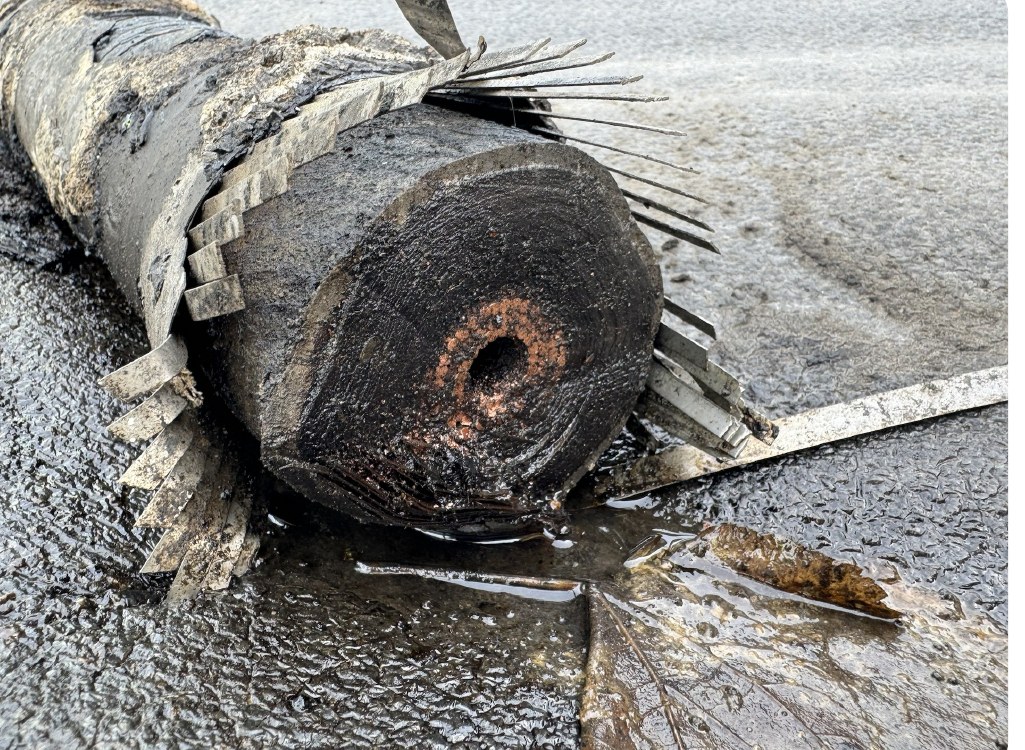

Sectioned 300kV oil-filled power cable lying on wet ground, dielectric oil pooling around the cut end
Exemplary 300kV cable from a bionrec project. Even after purging, dielectric oil remains bound in the paper insulation and continues to escape.
The situation

Purging never empties the cable.

Decommissioned oil cables must be secured against leaks — insulating oil is hazardous to soil and groundwater. Historically the only answer was excavation: costly, slow, and near-impossible to plan through urban traffic and private landownership.

Purging alone cannot clean a cable completely. The ODB System removes what remains, biologically, with the cable left in the ground.

How it works

Five stages, one biology.

Every ODB deployment follows the same sequence, calibrated to the cable's voltage class, oil chemistry and length. Repeat injections continue until verification sampling confirms the target removal efficiency.

  1. Dielectric oil seeping from a cut high-voltage cable end during on-site sampling
    01

    Oil sampling

    Oil is drawn from the cable and profiled for hydrocarbon ranges and contaminants — including PCB screening — to define the treatment plan.

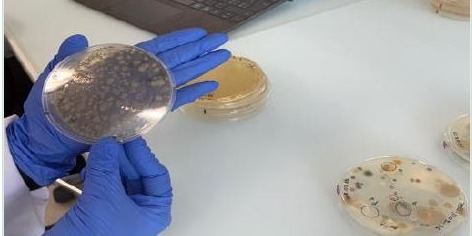

  2. Laboratory technician in nitrile gloves holding a culture plate of oil-degrading bacteria
    02

    Bacteria design

    Cultures are selected and grown against your cable's specific oil chemistry, then formulated with a matching biostimulation nutrient package.

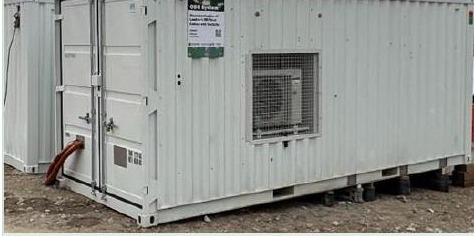

  3. Containerised bionrec treatment plant positioned on a substation site
    03

    Hardware prep

    A containerised treatment plant is delivered and commissioned — pumps, tanks, separators and monitoring in one unit.

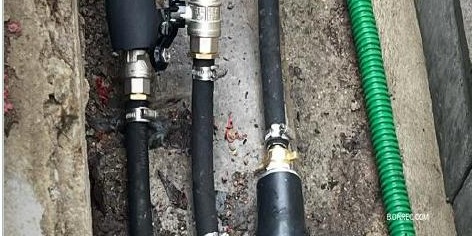

  4. Hoses connected to the sealing ends of an oil-filled cable in an open jointing bay
    04

    Cable connection

    The plant is connected to existing access points and the bacterial solution circulates through the cable's oil channel over repeated cycles.

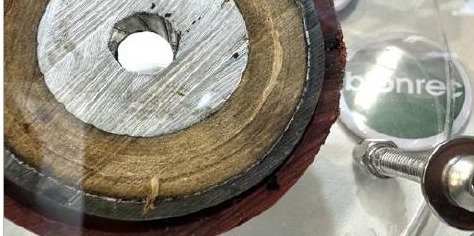

  5. Cored disc cut from a treated cable showing clean, dry paper insulation
    05

    Completion

    Verification sampling and cored sections confirm removal efficiency and produce the documentation needed before the cable is left in place or removed.

In the field

A container at each end. Nothing dug up in between.

Treatment plant is installed at the existing terminations at both ends of the circuit. The bacterial solution circulates through all three phases; a separator splits recovered oil waste — measurable by the client — from the solution returned to the cable. The cable itself stays in the ground for the full treatment window.

TREATMENT TIME — 4 TO 5 MONTHS2,6 kmLocation ALocation BPHASE 1PHASE 1PHASE 2PHASE 2PHASE 3PHASE 3CIRCUIT 1SeparatorSolution + bacteriaOil wasteDisposalMEASURABLE BY CLIENTSeparatorSolution + bacteriaOil wasteDisposalMEASURABLE BY CLIENT

Scroll sideways to view the full schematic

Typical ODB deployment across a 2.6 km three-phase feeder — treatment time four to five months. Effect: a biologically decommissioned cable, without excavation and with no further treatment needed.
Results

Documented on live grid infrastructure — not just in the lab.

0%
dielectric oil removed from paper matrix at minimum
0
16 weeks average treatment time
0
excavation or civil works required
0
kV — proven voltage class, incl. subsea cables
FAQ

ODB System, answered.

16 weeks on average from first injection to final verification sampling.

Have a site or a cable that needs to come clean? Tell us the scope — we'll tell you the timeline.
